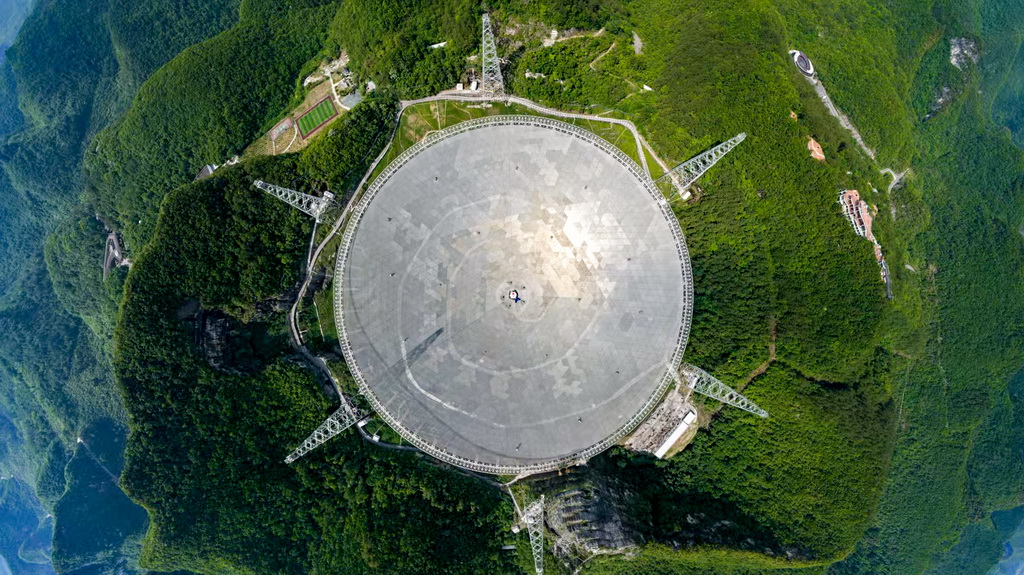

In the karst depressions of Guizhou province, the Five-hundred-meter Aperture Spherical Telescope (FAST) stands as a testament to human curiosity and engineering ambition. Known colloquially as the “Eye of China,” the massive radio telescope is designed to peer into the furthest reaches of the universe, hunting for pulsars and probing the mysteries of dark matter. Yet, for all its celestial reach, the telescope’s operational precision relies on a few critical, earthbound components: the steel cables that move its feed cabin.
For years, these high-precision cables—the “muscles” that allow the telescope to focus its gaze—were sourced from foreign suppliers. This dependence created a strategic vulnerability in the maintenance and longevity of one of the world’s most significant scientific instruments. Now, Chinese researchers have announced the successful nationalization of these components, marking a shift toward total technical autonomy for the facility.
The achievement is not merely a matter of manufacturing, but of extreme precision engineering. The feed cabin, which weighs approximately 30 metric tons, must be positioned with millimeter accuracy to capture faint radio signals from deep space. It operates within a massive void, suspended roughly 140 meters above the main reflector, moving across a diameter of 206 meters. Any slack, stretch, or failure in the cabling system would effectively blind the telescope.
Engineering the “Eye Muscles” of FAST
The transition to domestic cables began in January 2023, when a specialized research team launched a program to develop a home-grown alternative that could meet or exceed the specifications of the original foreign parts. The challenge lay in the cables’ need to withstand immense tension while maintaining absolute stability over thousands of movements.
To ensure the cables would not fail under the rigors of astronomical observation, the team subjected the prototypes to a grueling validation process. The development cycle included three distinct phases of optimization and a massive volume of stress testing to simulate years of wear and tear in a compressed timeframe.
- Pulley Performance: The cables underwent 62,000 operational trials on pulleys to ensure smooth movement and minimal friction.
- Fatigue Testing: To prevent structural failure, the team conducted 200,000 impulse fatigue tests, simulating the repetitive stress of positioning the 30-ton cabin.
- Material Optimization: Three cycles of refinement were used to tweak the steel composition and winding techniques for maximum durability.
This rigorous approach ensured that the new cables could handle the dynamic loads of the feed cabin without stretching—a critical requirement for the telescope’s real-time positioning capabilities.
Technical Specifications of the Feed Cabin System
| Component/Metric | Specification |
|---|---|
| Feed Cabin Weight | ~30 Metric Tons |
| Control Mechanism | 6 High-Precision Steel Cables |
| Operational Range | 206-meter diameter |
| Suspension Height | ~140 meters above reflector |
| Testing Volume | 262,000+ total stress/fatigue tests |
Strategic Autonomy and the Supply Chain
While the immediate goal was to replace aging cables, the broader implication of this project is the “localization” of scientific infrastructure. By removing reliance on foreign vendors, China secures its supply chain against geopolitical volatility and trade restrictions that have increasingly affected high-tech components in recent years.
Beyond the hardware, the project has allowed China to build a comprehensive internal knowledge base. The researchers have now established a full “competence chain,” meaning the country now possesses the domestic expertise to handle every stage of the process: from the raw material science of the steel to the fabrication of the cables, technical evaluation, and final quality control protocols.
This model of domestic substitution is expected to serve as a blueprint for other large-scale scientific projects within the country, reducing the “technological bottleneck” often encountered when maintaining complex, multi-decade infrastructure.
The Path to Full Implementation
The six newly manufactured domestic cables have already been transported to the Guizhou site. The replacement operation is currently underway, with engineers working to integrate the new “muscles” into the existing drive system. According to project timelines, the replacement work is expected to continue through the end of June.

Once the installation is complete, the feed cabin will undergo a series of calibration tests to ensure the domestic cables provide the same, or better, precision as their predecessors. This will ensure that FAST continues to operate at peak efficiency without interruption to its ongoing celestial surveys.
The next confirmed milestone for the project is the final technical verification of the cabin’s positioning accuracy following the completion of the cable replacement in late June.
